Kansas Asphalt Overlay Freshens Small Town USA
Shilling Construction’s asphalt overlay freshens small town USA
As the United States of America celebrates its 250th birthday this month, let’s look to one of the close-knit communities that makes up the fabric of our nation. For a small town in the Midwest, the team from Shilling Construction Company, Inc., Manhattan, Kansas, not only reminds us of the opportunity for steady work in the smaller stretches of connecting byways, but also of the pride the milling, paving and production crews can take in refreshing an older town’s aesthetics.
Small towns with long-standing community pride like Maple Hill, Kansas, dot the landscape of this great country. In partnership with the U.S. Department of Transportation, The Great American Road Trip is highlighting those towns, the historic landmarks within and around them, and the open asphalt roads connecting us to them. Visit The Great American Road Trip | Celebrating America’s 250th Birthday for information.

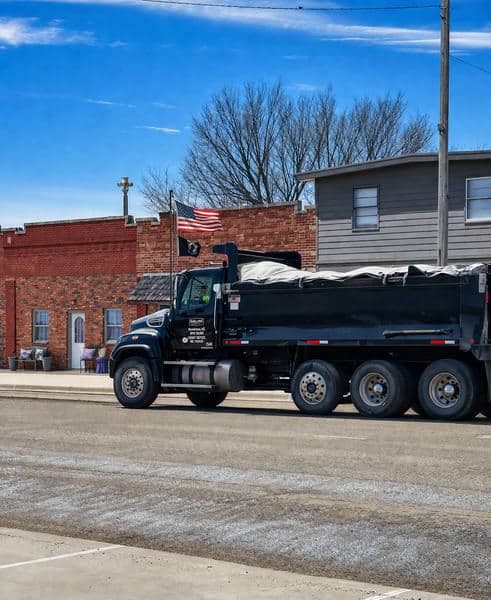

Maple Hill is nestled between I-70 to the south and US24 to the north in Kansas. According to City-Data.com, the town’s population in 2024 was 639. When Shilling Construction won the contract in late 2025 from Wabaunsee County to handle an overlay of County Road 30, Maple Hill’s cozy downtown strip benefited from a mill-and-fill as well.

As we celebrate the 250th birthday of the USA this month, one of the small towns that makes up the fabric of this nation has a fresh new look thanks to the mill-and-fill portion of Shilling Construction’s project from April. Along Main Street, the city of Maple Hill has clean edges and a safe, smooth surface again. City Clerk Lynn Hoobler said, “I think that overall, it gives the downtown a fresh and inviting look.”
Steve Altobello, the owner of Shilling Construction Company, Inc., spoke of the overall performance of this project for a rural township. “Maple Hill’s Main Street, like in so many communities, is the heart of the town. A quality asphalt paving project has a real impact. Shilling is a community driven company, and our people are honored to play a small part in improving Main Street. Taxpayers in counties and cities need their dollars deployed efficiently and effectively. We are proud our team delivered a high-quality product in a cost-effective way for Wabaunsee County and the city of Maple Hill.”
Daren Dieker is a superintendent for the company and shared how the project came together. “From our standpoint, this project really came down to coordination and timing, being able to complete Main Street while we were already mobilized for the surrounding work.”

The Shilling Construction team milled 1.5 inches of 0.9 miles for Maple City’s portion of the project. The milled surface was cleaned and tacked prior to paving.
County Overlay

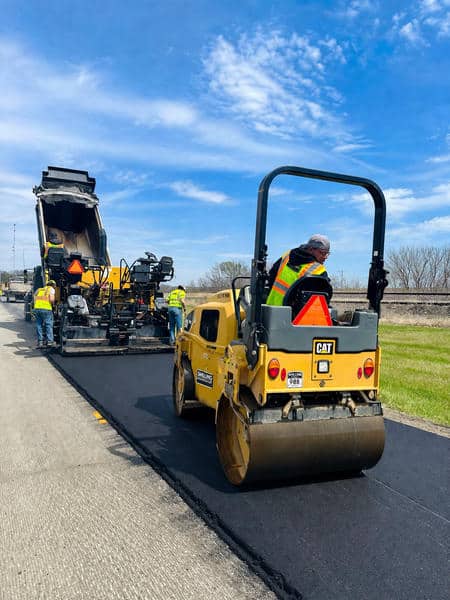

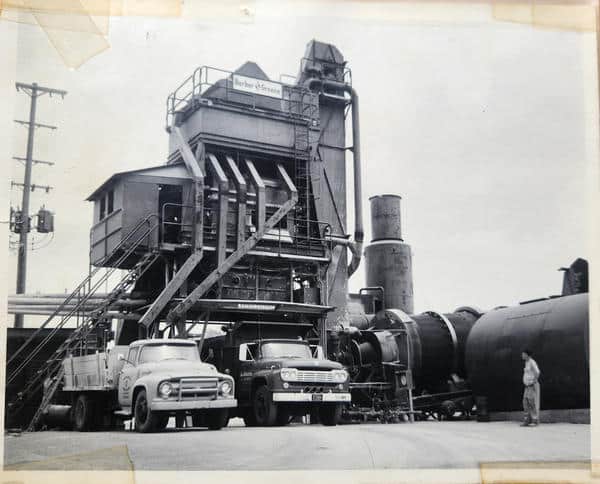

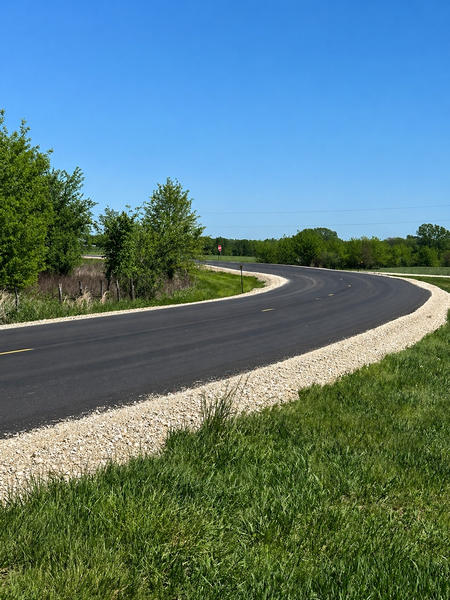

The “surrounding work” Dieker mentioned called for 2,362 tons of Class A mix with a PG58-28 binder and approximately 40% RAP on 2.4 miles of county road, and an additional 310 tons from the county for a side road. The crew produced this mix at their Astec plant located on Manhattan’s McDowell Creek Road, about 40 minutes from the project, at an average temperature of around 310°F. Then they placed it with a CAT 1055F paver in a single lift at approximately 1.75 inches to achieve 1.5 inches after compaction.

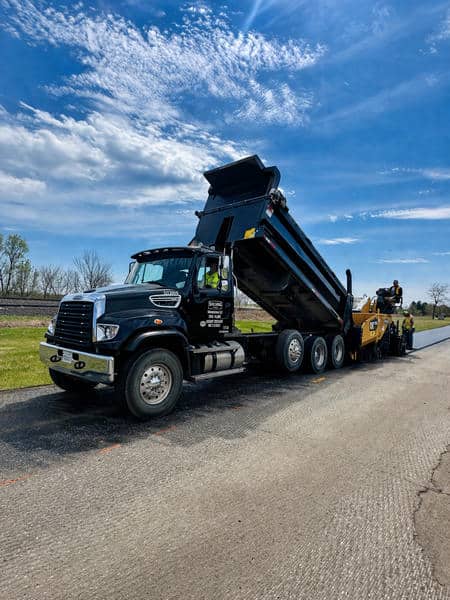

Trucks charged the CAT 1055F paver’s hopper directly with a Class A mix of PG58-28 binder and approximately 40% RAP, delivered from the Manhattan plant about 40 minutes away.
The project ran from April 6-21, 2026, so the team kept an eye on the Midwest spring temperatures.
“Ambient conditions during paving ranged from 45 to 65 degrees,” Dieker explained. “With an approximate 40-minute haul time, we did not experience temperature loss issues. Our trucks are equipped with electric tarps, which kept the mix well covered during transport.”

Lynn Hoobler, city clerk for Maple Hill, spoke of the quality work from Shilling Construction, both during and because of the job. “We have a new restaurant in town, and I hope it gives visitors a positive outlook of the town. I know the owner was concerned that she would lose business, for lack of parking, but Shilling was efficient and I didn’t get any negative feedback about that. Shilling did a great job as far as traffic control with the pilot cars bringing traffic in and out safely.”
Main Street Mill-and-Fill

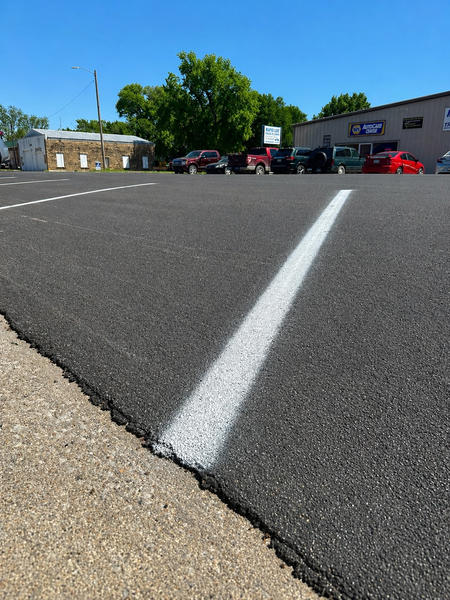

The Main Street portion of the project ran through downtown Maple Hill and covered approximately 0.9 miles, including the parking stalls. Lynn Hoobler, the city clerk, shared that the road coming into town had a significant amount of potholes.
“The road coming into the city limits is called Elm Street, and a lot of potholes were becoming a major issue for the city. Main Street was also getting well worn, to say the least, and was really getting ugly. The county would do an overlay project every couple of years, but they only did 12 feet on each side of the center line. After years of that, there was a 5-inch [trough] or maybe more, creating a hazard for citizens crossing the street.”

Superintendent Daren Dieker shared that the Class A mix with 40% RAP performed well for the rolling train. On the county road, the team achieved average densities of 93.5% on the mainline and 92% on the joint.

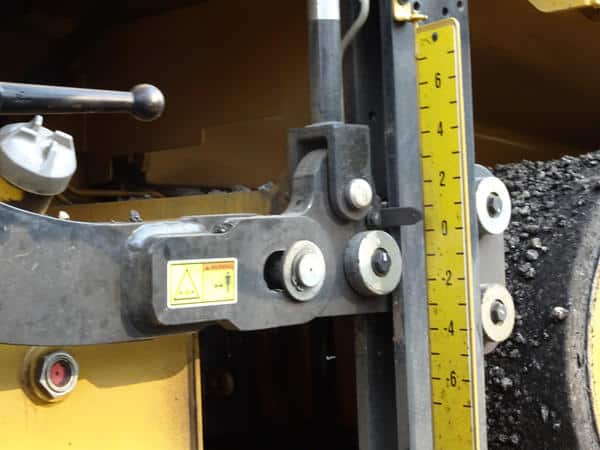

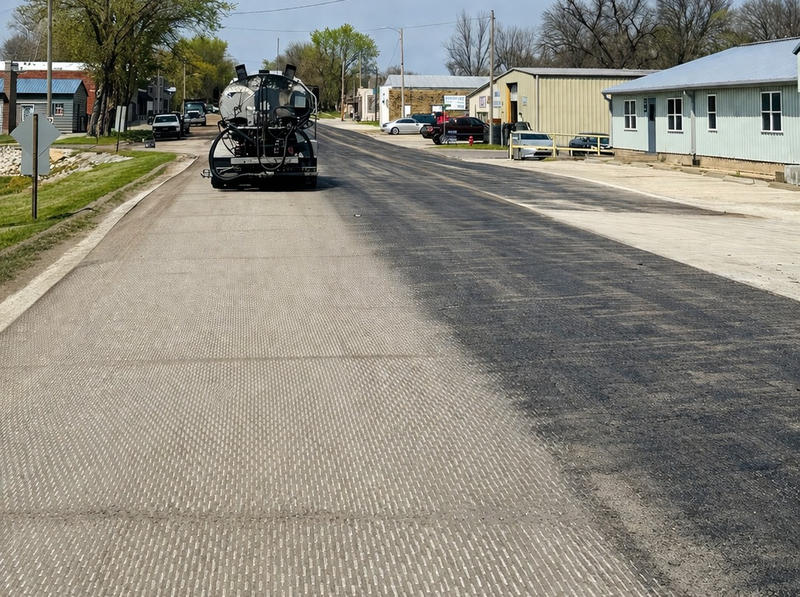

The crew used a W 200 Fi milling machine from Wirtgen for the 1.5-inch mill-and-fill. Dieker shared that they controlled the milling depth manually.
“All millings from the project were either sold or provided to the city,” Dieker explained. “Our plant maintains sufficient stockpile to support [the 40%] RAP mix.”
The city’s maintenance personnel handled striping upon completion of the paving. Shilling Construction’s team used the same mix, equipment and rolling train along Main Street as they did on the surrounding county work.

The team used a Cat CB34B roller in the breakdown position and a Sakai SW994 for finish. This combination served so well in town that it was continued for the entirety of the project.
Compaction Completion
The rolling train included a Cat CB34B for breakdown rolling and a Sakai SW994 for finish rolling—both double steel drum rollers. “This combination performed well in town and was carried through the remainder of the project,” Dieker shared.
The only notable soft area they encountered was along the parking stalls in town. With an experienced crew, this challenge was quickly solved. “The crew addressed this by adding additional mix and depth in those locations,” Dieker explained.

To achieve a smooth, sealed finish, the rollers focused on quality control.
“The crew focused early attention on the longitudinal joints, with the smaller roller compacting the joint as soon as possible to ensure density and a clean finish,” Dieker explained. “The mix performed well under the rollers. Density was verified using our in-house nuclear density gauge. We were seeing an average density of 93.5% on the mainline and 92% on the joint on the county road.”

The team used a Cat CB34B roller in the breakdown position and a Sakai SW994 for finish. This combination served so well in town that it was continued for the entirety of the project.
Delivering the seamless new surface between I-70 and US24 took communication among multiple stakeholders.
“We appreciate the coordination and partnership throughout the project,” Josh Hinch of Wabaunsee County said. “The finished roadway looks great and provides a smoother, safer surface for the traveling public.”
Kansas Turnpike Turns to Asphalt for Fast, Reliable Upgrades
“Shilling did a great job as far as traffic control with the pilot cars bringing traffic in and out safely,” Hoobler shared. “I am the city clerk, so I had a front and center view of the project. The employees were polite and respectful to our residents at all times, too. They were friendly and courteous when they were waiting for their turn to do their part of the job. Overall, the new overlay is really nice, smooth, and makes the city look fresh. I think that overall, it gives the downtown a fresh and inviting look.
